Shean Trail Crossing Update: Temporary Access Restriction Lifted
posted August 13, 2026
Shean Trail Crossing Update: Temporary Access Restriction Lifted
The temporary access restriction across Central Avenue for the Shean Trail crossing has been lifted. Effective immediately, the crossing, which is a part of the Celtic Shores Coastal Trail, is now reopened for trail users following the progression of infrastructure work related to the Central Avenue Rebuild Project.
Trail users are advised to use caution when passing through the area, as the crossing remains within the active construction zone. Users should follow all posted signage and barricades and be mindful of road conditions, ongoing construction activities, and traffic.
The Municipality thanks residents and trail users for their patience and understanding as the Central Avenue Rebuild Project continues to progress.

Central Avenue Rebuild

Stay Informed

Newsletter Sign-Up:

  • Interested in receiving project updates directly to your email inbox? Sign up here.

Past Newsletters:

Upcoming Events:

Project Information Centre

Residents are invited to drop in and speak directly with a municipal representative about the project. The Project Information Centre will open on select days from 1 p.m. to 4 p.m.

  • Location: Inverness Fire Hall, 15797 Central Ave., Inverness
  • August Dates:
    • Tuesday, August 4
    • Thursday, August 6
    • Tuesday, August 11
    • Thursday, August 13
    • Tuesday, August 18
    • Thursday, August 20
  • Hours: 1 p.m. to 4 p.m.

Please note that hours are subject to change. Residents are encouraged to check here for updates.

Community Open House

The Municipality of Inverness County hosted two open house sessions, July 28 and 30, 2026 at the Inverness Fire Hall, where attendees had the opportunity to learn about the Central Avenue Rebuild project, meet with municipal representatives, ask questions, and find out about other municipal projects, programs and services available in the community. We thank those who took the time to attend.

News Releases:

Resources:

Questions:


About the Project:

The Central Avenue Rebuild project involves a full reconstruction of Central Avenue, including:

  • New water and wastewater piping and associated infrastructure.
  • Replacement of an existing wastewater lift station located at the Central Avenue trail crossing.
  • Improved sidewalks, multi-use paths, and crosswalks.
  • Streetscape and beautification enhancements.
  • A fully reconstructed roadway with upgraded stormwater systems, delivered in partnership with the Nova Scotia Department of Public Works.

To learn more about these project elements, check out the glossary of terms here.

Project Location Timeline:The project will be completed in phases over approximately two kilometres of Central Avenue, Inverness.

Phase One:

  • Extends from the intersection of Broad Cove Banks Road to James Street.
  • Construction is expected to begin in early July and continue through December 2026.

Future Phases:

  • Planned to continue from James Street to the Inverness County Centre for the Arts (ICCA) driveway and include additional infrastructure upgrades, such as a new wastewater lift station at the ICCA driveway.
  • The timing and scope of future phases will depend on market volatility and contractor availability.

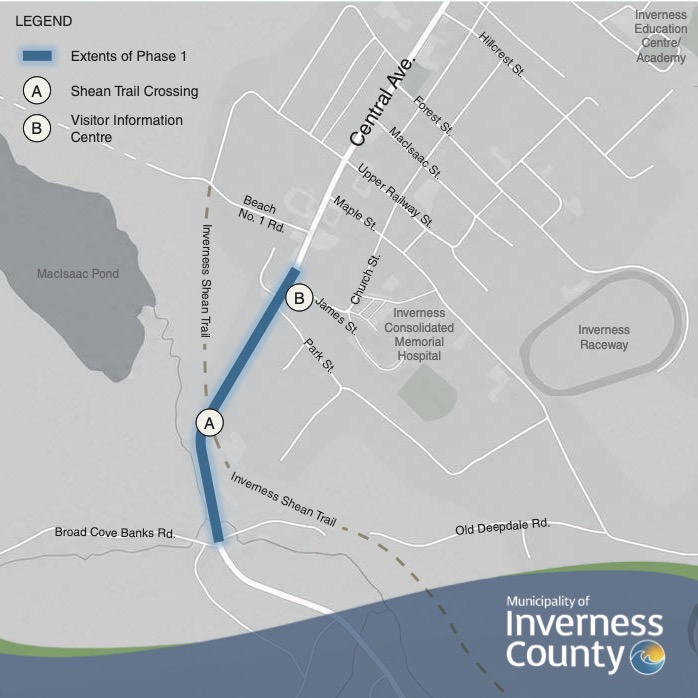

Central Avenue Project Map

Project Timeline

  • Tender issued: April 20, 2026
  • Tender closed: May 15, 2026
  • Tender awarded: May 22, 2026
  • Phase One kick-off: Late June 2026
  • Phase One completion: December 2026

What Residents Can Expect

Construction will create temporary impacts for residents, businesses, commuters, and visitors. The Municipality will work closely with the contractor to minimize disruptions wherever possible and maintain access to homes, businesses, and community facilities throughout construction.

From Monday to Friday, traffic control measures will begin at 6:30 a.m., with roadwork starting at 7 a.m. (previously 8 a.m.). Work is expected to conclude each day by 5 p.m., unless unforeseen circumstances require additional time.


Why this Project is Needed:

2019 assessment of the Municipality’s water and wastewater systems identified significant concerns with aging infrastructure along the corridor.

The assessment found that key infrastructure assets had reached the end of their service life and were at increasing risk of failure. Without replacement, these conditions could lead to service disruptions, environmental impacts, and public health concerns.


Central Avenue Rebuild Project Benefits

Once complete, the project will provide:

  • Reliable water and wastewater services.
  • Reduced risk of service interruptions and infrastructure failures.
  • Improved pedestrian safety and accessibility.
  • Enhanced streetscape and community appearance.
  • Increased infrastructure capacity to support future growth and development.

Project Partners & Responsibilities (to date):

  • Design – Water/Wastewater & Storm Systems: R.V. Anderson Ltd.
  • Design – Streetscaping & Active Transportation: Englobe Corp. & Upland Planning & Design
  • Road Reconstruction & Storm Infrastructure Replacement: Nova Scotia Department of Public Works
  • General Contractor: Brilun Construction Ltd.

Permit & Oversight Agencies

This project is highly regulated, and several permits have been secured from various agencies, including:

  • Nova Scotia Regulatory and Appeals Board
  • Nova Scotia Department of Environment & Climate Change
  • Nova Scotia Department of Public Works
  • Nova Scotia Power
  • Federal Department of Fisheries and Oceans

In addition, archaeological monitoring will take place as required based on a completed Archaeological Resources Impact Assessment in alignment with federal funding program requirements.

The municipality has reached out to engage with private property owners impacted by the project.


Project History

Central Avenue Rebuild is one component of a broader generational investment in infrastructure improvements throughout the community of Inverness. Related projects include:

Together, these investments are helping renew aging infrastructure, improve environmental performance, enhance safety and accessibility, and support future growth in the community.


Acknowledgement of Challenges

The Municipality of Inverness County acknowledges that this is a challenging time for public-facing projects due to supply chain disruptions, market fluctuations, and contractor availability. While we strive to provide the most accurate information, please understand that project timelines, costs, and other details are subject to change. We will keep the public informed with updates as they become available.

This could be a link on the page: (Will also have an FAQ document currently being designed so could also be a link?)


Budget

This project is funded through a three-level government partnership, municipal, provincial, and federal, under the Investing in Canada Infrastructure Program.

The total for the project is $8,355,733, with the Municipality covering $1.87 million.
